Emergency Rental Chillers in Oklahoma: When to Deploy, How Fast, and What You Need On-Site
Guide October 20, 2025 by Total Mechanical Services

Emergency Rental Chillers in Oklahoma: When to Deploy, How Fast, and What You Need On-Site

A practical guide for Oklahoma facilities on emergency rental chillers: triggers to deploy, what tonnage you may need, site requirements, timelines, and cost drivers.

Emergency Rental Chillers in Oklahoma: When to Deploy, How Fast, and What You Need On-Site

Emergency rental chillers are not just for mega-events—they’re a proven way to keep critical cooling online when repairs, parts, or system recovery will take longer than your operation can tolerate. In Oklahoma, we see rental needs spike during extended heat events, when condenser-side problems cascade, or when a critical facility can’t risk even a day of downtime. This guide explains when a rental makes sense, what information to gather, and how to prepare your site so a rental deployment doesn’t become a second emergency.

Quick Answer: Should you call about a rental chiller?

If your building cannot tolerate losing chilled water for more than 6–24 hours (healthcare, process, IT), or if your chiller is down with an uncertain repair timeline, you should start the rental conversation immediately. Rentals require power, safe hose routing, and a connection plan; the earlier you plan, the faster you can get temporary cooling operating and stabilize the facility.

To decide faster in the field, run this in parallel with our first-60-minutes emergency HVAC response checklist.

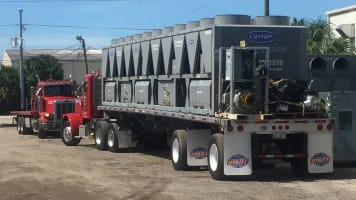

Emergency rental chiller deployed at Oklahoma commercial facility

Photo credit: Carrier

When rental chillers are the right move

We recommend considering a rental chiller when any of these are true:

SituationWhy Rental Makes SenseUrgency Level
Critical load at riskHealthcare, data center, process cooling cannot waitImmediate
Unknown downtimeCompressor failure, controls board, major leakHigh
Parts lead timeOEM parts not available same-day or next-dayHigh
Cascading failure riskRunning “half-working” may damage more equipmentHigh
High ambient eventPeak summer with no margin for reduced capacityHigh
Planned replacement bridgeAvoid shutdown during equipment changeoverPlanned
  • Critical load: hospital ORs, imaging, pharmacy, data centers, process cooling
  • Unknown downtime: compressor, controls boards, major refrigerant leak, or multiple failures
  • Parts lead time: OEM parts not available same-day
  • Risk of cascading failures: the longer you run “half-working,” the more likely more equipment fails
  • High ambient event: peak summer weeks where “limping along” is not realistic

Rentals can also be a bridge during planned replacement projects to avoid shutdown windows.

When a rental chiller is NOT the best first option

Not every outage needs a rental. Rentals may not be the fastest option if:

SituationBetter First OptionWhy
Condenser-side issue (coil fouling, tower staging)On-site cleaning/repairFaster resolution, lower cost
Redundant chillers availableOperate on reduced capacityAlready have backup
Airside issue (AHU down)AHU repairChilled water isn’t the constraint
Short repair timeline (under 4 hours)Wait for repairRental setup takes time too
  • A straightforward condenser-side issue can restore operation quickly (coil cleaning, tower staging)
  • Your facility has redundant chillers and can operate on reduced capacity temporarily
  • The real constraint is distribution (airside) rather than chilled water (e.g., a critical AHU is down)

The right sequence is: triage → stabilize → determine timeline → decide rental.

How to estimate tonnage (without guessing)

The most common mistake we see is undersizing or oversizing because someone picks a “round number.” Use one of these methods:

Method A: Use your actual equipment nameplate and trend data

  • Identify the tonnage of the failed chiller(s)
  • Determine whether you need full capacity or a critical subset
  • Review BAS trends: peak CHW flow and temperature differential

Method B: Use a “critical load” approach

If the whole building doesn’t need to stay at 72°F, prioritize:

  • server rooms / IT closets that overheat first
  • imaging equipment
  • OR suites / recovery
  • process areas with heat-sensitive equipment

This often reduces required tonnage significantly.

Method C: Rule-of-thumb checks (only as a starting point)

Rule-of-thumb tonnage per square foot can be misleading. Use it only to sanity-check your planning, not as the final answer. Oklahoma humidity and load profiles can make the “average” numbers wrong quickly.

Sizing MethodAccuracyBest Used When
Nameplate + BAS trendsHighData available, replacing specific chiller
Critical load calculationMedium-HighPrioritizing essential areas only
Square footage rule-of-thumbLowQuick sanity check only
Prior rental experienceMediumSame facility, similar conditions

Typical rental tonnage ranges (what’s realistic)

Rental fleets often support a wide range, and multi-unit staging is common:

Tonnage RangeTypical ApplicationsPower Considerations
50-100 tonsTargeted critical loads, smaller facilities, spot cooling loopsOften 480V, may work with existing capacity
150-300 tonsMid-size plants, multi-story buildings, partial operationsRequires dedicated power planning
400-500+ tonsLarge campuses, convention/hospitality, industrial/processOften requires generator or utility coordination

The best approach is to plan a rental that fits your power and connection realities.

Site requirements checklist (what you need ready)

Rental chillers are not “plug and play” unless your site is prepared. Here’s what we confirm before deployment:

Requirement CategoryKey QuestionsCommon Issues
Electrical powerWhat voltage/phase? Spare breaker capacity? Generator tie-in?Insufficient capacity, wrong voltage
Connection pointsHose connections available? Isolation valves?No planned tie-in points
Hose routingSafe path? Traffic protection? Insulation needed?Blocked egress, sun exposure
Heat rejectionAir-cooled space? Tower connection possible?Insufficient airflow, no tower access
Controls/monitoringHow will you monitor temps and alarms?No monitoring plan

1) Electrical power

  • What voltage/phase is available?
  • Is there a spare breaker capacity or generator tie-in?
  • Where is the safe connection point?

Power constraints often drive whether you use one large unit or multiple smaller units.

2) Connection points (water-side)

You need a safe way to connect the rental into your chilled water loop:

  • existing hose connections (ideal)
  • temporary tie-in points with isolation valves
  • piping access for a controlled tie-in

Also plan for:

  • strainer protection
  • air removal / venting
  • flow verification

3) Hose routing and safety

Hose runs need:

  • safe paths that won’t block egress
  • protection from vehicle traffic
  • insulation or protection if exposed to sun/heat
  • clear labeling and signage

4) Heat rejection plan

Depending on the rental type:

  • air-cooled rental rejects heat via its own condenser (space and airflow matter)
  • water-cooled rental may require tower connection or temporary heat rejection

5) Controls and monitoring

Even temporary systems need monitoring:

  • supply/return temps
  • flow
  • alarms
  • minimum staffing plan for after-hours checks

Timeline: how fast can a rental chiller be online?

Timeline depends on:

  • availability
  • site readiness (power + tie-in plan)
  • equipment complexity
  • weather and logistics
Site Readiness LevelTypical Deployment TimeWhat Makes It Faster
Pre-planned connections, power ready4-8 hours from arrivalExisting hose bibs, known power source
Some infrastructure, planning needed8-24 hoursCoordination, minor tie-in work
No prep, emergency scramble24-48+ hoursEverything done under pressure

The fastest deployments happen when the facility:

  • has clear tie-in points,
  • has a known power plan,
  • and can give the rental team safe access.

Hours to Operational

Unprepared Site 48 hrs
48 hrs
Pre-Planned Site 8 hrs
83% Reduction

Saved 40 hrs

Cost drivers (what makes rentals expensive)

Rental cost depends on:

Cost FactorLower CostHigher Cost
TonnageMatch to critical load onlyOversized “just in case”
DurationDaysWeeks or months
Mobilization timingBusiness hoursAfter-hours, weekends, holidays
Site prepPre-planned connectionsEmergency tie-in labor
ConsumablesStandard fittingsCustom piping, long hose runs
MonitoringSelf-monitored24/7 service support
  • tonnage and configuration
  • duration (days vs weeks)
  • electrical and piping labor
  • after-hours mobilization
  • consumables (hoses, fittings, temporary piping)
  • monitoring/support requirements

The best way to control cost is to reduce scope to critical loads and prepare the site before the truck rolls.

When this is part of a broader replacement decision, align rental assumptions with the commercial chiller TCO framework so temporary and permanent costs are evaluated together.

Oklahoma-specific deployment notes

Oklahoma FactorRental ConsiderationPlanning Action
Heat events (100°F+)Air-cooled units may deratePlan for additional capacity margin
Dust and windCoil fouling during deploymentSchedule coil cleaning, consider protection
Storm seasonPower instabilityGenerator backup plan
Winter ice eventsHose/piping freeze riskInsulation, heat trace if running in cold
  • Heat events: plan for additional derate and ensure airflow for air-cooled rentals
  • Dust/wind: consider coil protection and cleaning cadence
  • Storm season: plan for power instability and generator coordination
  • Ice events: protect temporary hoses/piping from freeze risk if running during winter

For peak-summer derate planning before deployment, use Oklahoma heat dome HVAC protection guidance.

What to have ready when you call (speeds up sizing and dispatch)

Information NeededWhere to Find ItWhy It Helps
Building address and accessFacility recordsLogistics planning
Current chiller make/model/statusNameplate, BASSizing baseline
BAS data (CHW temps, flows)Building automationLoad calculation
Desired outcomeYour judgmentScope definition
Power availabilityElectrical recordsEquipment selection
Photos of tie-in locationsSite walkthroughConnection planning
  • Building address and access constraints
  • Current chiller make/model and status
  • BAS data: CHW temps, flows, critical zones
  • Desired outcome: “keep ORs and imaging stable” vs “cool the entire building”
  • Power availability details (voltage/phase/breaker capacity)
  • Photos of potential tie-in locations (if you can)

Need emergency rental chiller planning in Oklahoma?

Total Mechanical Services can help you evaluate whether a rental chiller is the right move and coordinate the deployment plan. Call (405) 223-9900 or request a proposal.


Disclaimer: Rental chiller deployments involve temporary electrical and piping work that must be planned and executed safely. This guide is informational and does not replace engineering review, OEM guidance, or site safety policies.
